What do you mean by earned value analysis?

Earned Value Analysis (EVA) is a method that allows the project manager to measure the amount of work actually performed on a project beyond the basic review of cost and schedule reports. ... Oftentimes the term “earned value” is defined as the “budgeted cost of worked performed” or BCWP.
In Earned Value Analysis (EVA) everything is measured and reported as money or monetary equivalent. The project team determines an equivalence between Scope, Schedule, Cost to do this. EVA provides a singular view of Scope, Schedule and Cost.
How is earned value analysis calculated?
The Formula for Earned Value (EV)
The formula to calculate Earned Value is also simple. Take the actual percentage of the completed work and multiply it by the project budget and you will get the Earned Value. Earned Value = % of completed work X BAC (Budget at Completion).
What are the 2 variables in earned value analysis?
Earned Value Analysis – EVA – Basics and Concepts
The main EVA variables (indicators) are: BCWS (Budgeted Cost of Work Scheduled) - PV (Planned Value) BCWP (Budgeted Cost of Work Performed) - EV (Earned Value)
What are earned value indicators?
Earned value is an early indicator and forecaster of project progress. Earned value shows a “three dimensional” view of project progress. Find out how earned value links to the work breakdown structure, the schedule, and the budget.Jan 14, 2009
What is earned value in PMP?
Earned value (EV) is a way to measure and monitor the level of work completed on a project against the plan. Simply put, it's a quick way to tell if you're behind schedule or over budget on your project. You can calculate the EV of a project by multiplying the percentage complete by the total project budget.
What is progressive elaboration in PMP?
Overview. Progressive elaboration involves continuously improving and detailing a plan as more detailed and specific information and more accurate estimates become available. Progressive elaboration allows a project management team to define work and manage it to a greater level of detail as the project evolves.Jul 21, 2019
What is CPI and SPI?
The Cost Performance Index (CPI) is defined as the ratio of Earned Value to Actual Cost, while the Schedule Performance Index (SPI) is defined as the ratio of cumulative Earned Value to cumulative Planned Value (PMI, 2000). Both CPI and SPI are traditionally defined in terms of the cumulative values.
What is PV EV and AC?
Planned Value (PV) = the budgeted amount through the current reporting period. Actual Cost (AC) = actual costs to date. Earned Value (EV) = total project budget multiplied by the % of project completion.Aug 21, 2019
What is the purpose of earned value?
Earned value provides an objective measurement of how much work has been accomplished on a project. Using the earned value process, the management team can readily compare how much work has actually been completed against the amount of work planned to be accomplished.

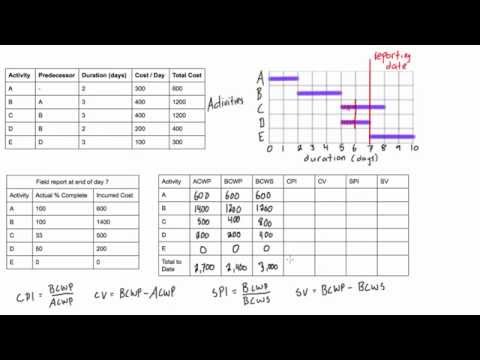

How is EVM calculated example?
The EV (Earned Value) is calculated by multiplying the Actual % Complete with the planned cost. If we take task 3 as an example, we multiply 50% by 3,600 which gives us 1,800 in Earned Value for this task. The PV (Planned Value) is calculated by multiplying the planned level of completion by the planned cost.


Related questions
Related
What is the 50 50 rule?
The 50/50 Rule is a progress technique for how to determine the earned value (EV). A work package's progress technique determines how earned value is calculated. Earned value measures the performance of a work package. The 50/50 rule assigns 50% of the value at the start and 50% when complete.Feb 5, 2021
Related
What are the five dimensions that must be managed on a project?
Projects should be measured on five specific dimensions: efficiency, customer, business-now, business-future, and team success. From these dimensions, business measures, customer measures, and process measures should form the basis for creating various metrics to measure the project manager.Sep 6, 2017
Related
What is the difference between programs and portfolios?
A program is a group of projects that are similar or related to one another, and which are often managed and coordinated as a group instead of independently. A portfolio is a group of different programs and/or projects within the same organization, which may be related or unrelated to one another.Jan 27, 2020
Related
What is the difference between rolling wave and progressive elaboration?
Progressive elaboration is the opposite of rolling wave planning. ... Rolling wave planning is a form of progressive elaboration where details are planned for work closer to the present time. Details for future work is planned out only at a high level. Progressive elaboration is not detailed or accurate.
Related
How do you calculate earned value?
- The formula to calculate earned value is the project budget multiplied by the percentage of work completed up until the date in question. For example, consider a project with a budget of $30,000 and 200 work hours. After the employees have completed 100 work hours, the earned value is $30,000 multiplied by 0.5, or $15,000.
Related
How to calculate earned value?
- Earned Value (EV): % complete x BAC. That is percent complete from progress measurement multiplied by the budget at completion. Additionally,one can ...
- Planned Value (PV): The authorized budget assigned to scheduled work– usually at the control account level.
- Cost Variance (CV): EV – AC. AC stands for actual cost.
- Schedule Variance (SV): Calculated as EV – PV.
- Schedule Performance Index (SPI): Calculated as EV/PV.
- Cost Performance Index (CPI): Calculated as EV/AC.
- Variance at Completion (VAC): BAC – EAC. This is Budget at Completion minus EAC Estimate at completion.
Related
What is Earned Value methodology?
- Earned value management (EVM) is a powerful methodology that gives executives, project managers, and other stakeholders the ability to visualize project status throughout the project life cycle and consequently manage projects, programs, and portfolios more effectively.
Related
What is Earned Value Analysis (Eva)?What is Earned Value Analysis (Eva)?
What is Earned Value Analysis? Earned Value Analysis (EVA) is a method that allows the project manager to measure the amount of work actually performed on a project beyond the basic review of cost and schedule reports. EVA provides a method that permits the project to be measured by progress achieved.
Related
What is earnearned value analysis and why is it important?What is earnearned value analysis and why is it important?
Earned value analysis is the project management tool that is used to measure project progress. It compares the actual work completed at any time to the original budget and schedule. It forecasts the final budget and schedule and analyzes the path to get there. It gives you the essential early warning signal that things are going awry.
Related
What is the earned value of a project?What is the earned value of a project?
Oftentimes the term “earned value” is defined as the “budgeted cost of worked performed” or BCWP. This budgeted cost of work performed measure enables the project manager to compute performance indices or burn rates for cost and schedule performance, which provides information on how well the project is doing...
Related
What is Earned Value Management (EVM)?What is Earned Value Management (EVM)?
Earned Value Management is a comprehensive yet not over-sophisticated methodology that allows project managers to measure and monitor the performance of a project. Thereby, the Earned Value Analysis focuses on the measurement of cost and value.
